Wednesday 10th June 2026 – Turks and Caicos Islands
Questions Raised Over Infrastructure Project Following Contract Award, Suspension, and Eventual Collapse
A Government road infrastructure project valued at approximately $2 million plus has become the subject of growing scrutiny after documents reveal that a contract awarded to RT Group of Companies Ltd was first suspended and later terminated, despite the contractor claiming to have already undertaken procurement and mobilization activities.

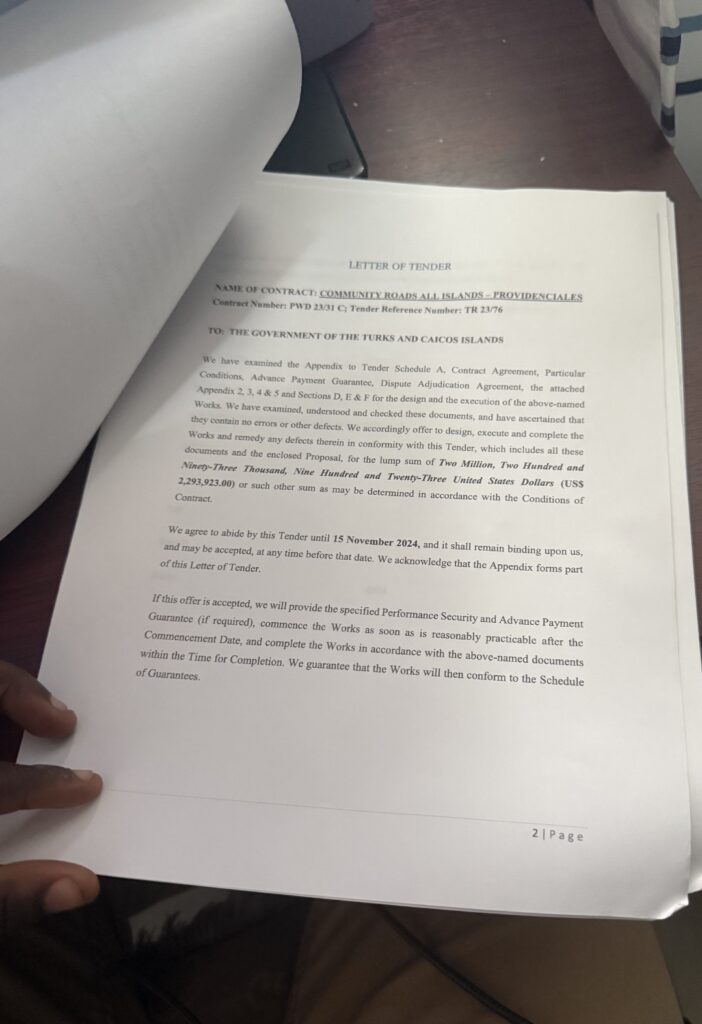

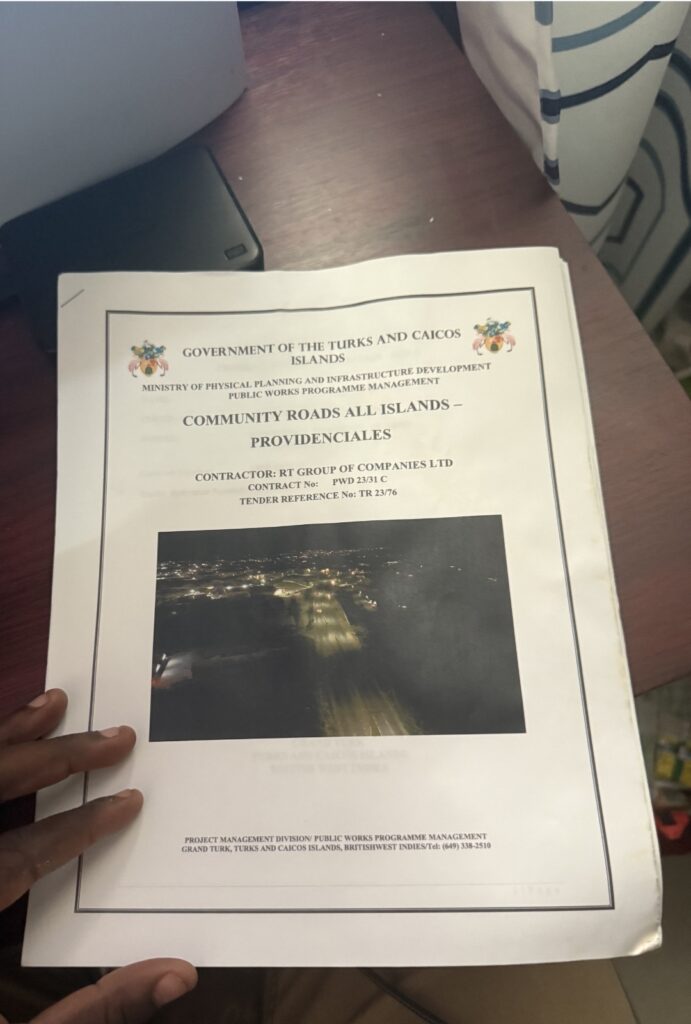

Documents reviewed by Eagle Legal News show that the Government of the Turks and Caicos Islands entered into a contractual agreement with RT Group for the Community Roads possibly all Islands or just Millennium Highway and Blue Hills, Providenciales. The project, a contract reportedly worth approximately $2 million plus and intended to deliver road infrastructure improvements in Providenciales.

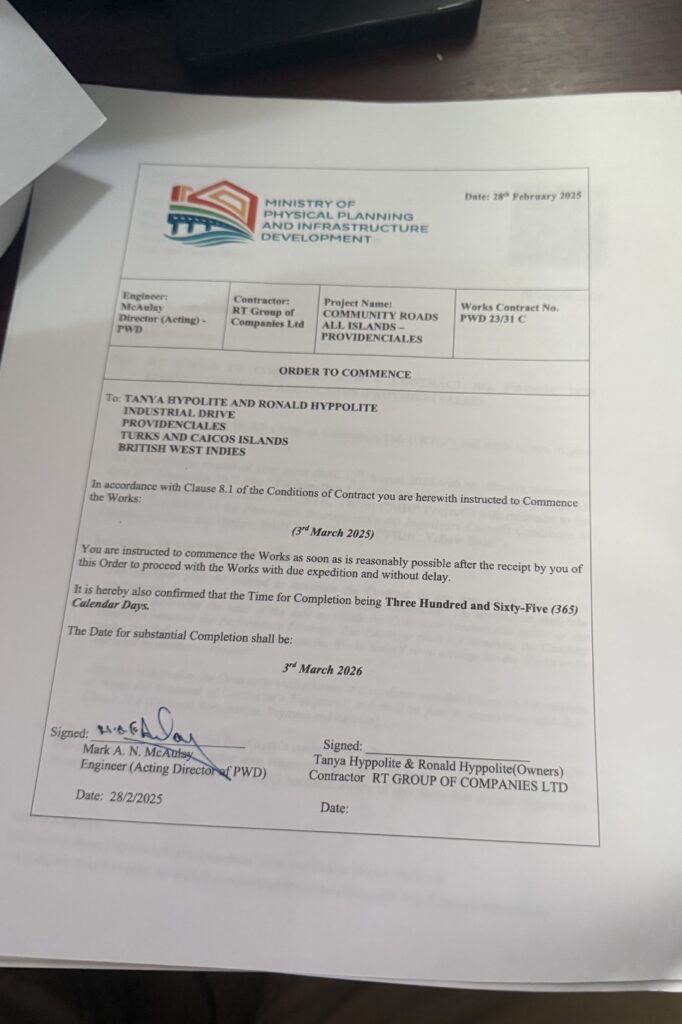

According to the records, the contractor was formally engaged, contractual arrangements were executed, and an Order to Commence was subsequently issued.
However, despite those steps being taken, the project was later suspended by Government and then eventually being terminated.
The documents leave a number of unanswered questions regarding how a Government contract worth approximately $2 million progressed from commencement to cancellation.
Contractor Says Procurement Had Already Begun
Records contained within the project file indicate that RT Group had already begun procurement and mobilization efforts connected to the project.
The documents reference expenditures relating to construction materials, equipment, engineering services, surveying services, legal services, logistics, shipping, and other project-related activities involving suppliers in the Turks and Caicos Islands, the Dominican Republic, Panama, China, the United Kingdom, and the United States.
The contractor’s position appears to be that these commitments were made in reliance upon a Government contract and official instructions to proceed with the works.
Whether all of those expenditures are ultimately recoverable remains a matter of dispute and civil proceedings.
Government Orders Suspension

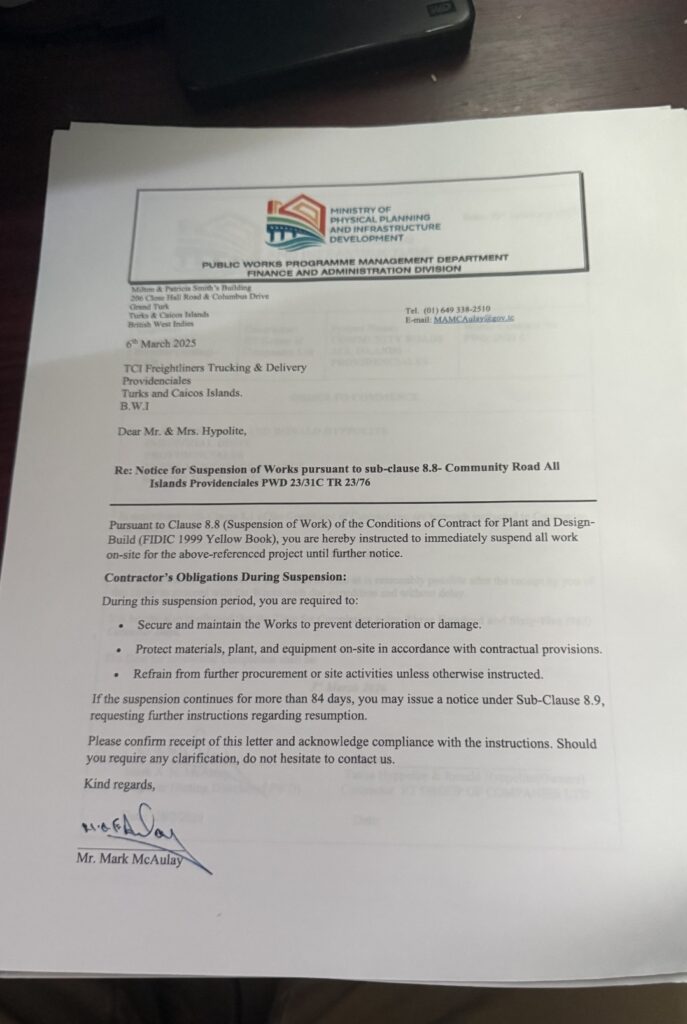

The project later took a dramatic turn when Government issued a formal Notice of Suspension of Works.
The contractor was directed to cease operations, secure equipment and materials, and halt project activities pending further instructions.
The suspension raises obvious questions.
Why was a contractor instructed to mobilize and proceed with a Government project valued at approximately $2 million, only to later be ordered to stop?
What circumstances changed between the issuance of the Order to Commence and the decision to suspend the works?
The documents reviewed provide evidence of the suspension itself but do not appear to contain any detailed public explanation for addressing those questions.
Dispute Escalates
The matter subsequently developed into a legal dispute.
Correspondence from attorneys representing RT Group argues that the contractor incurred costs and entered into commitments in preparation for carrying out the project.
Government officials, on the other hand, appear to have examined the contractor’s claims and the extent to which certain expenditures may be recoverable under the contract.
The dispute ultimately moved beyond construction and into a contractual disagreement concerning obligations, expenditures, and compensation.
Political Accountability Questions Emerge
The controversy is also likely to generate political discussion.
Infrastructure development was a major talking point during the last general election campaign by the Deputy Premier, Hon Jamel Robinsin, who was responsible at the time. The goverment road improvements regularly featured as part of the Government’s development agenda.
The Minister responsible for Physical Planning and Infrastructure Development at the relevant time fell under the portfolio of Hon. Arlington “Chuck” Musgrove.
While the documents reviewed do not indicate that Hon. Musgrove personally made the decision to suspend or terminate the contract, the project fell under the ministry for which he held responsibility. As a result, questions regarding oversight, project management, and decision-making are likely to arise.
Residents may reasonably ask how a Government project worth approximately $2 million progressed from contract award, to commencement, to suspension, and ultimately termination.
Contract Eventually Terminated

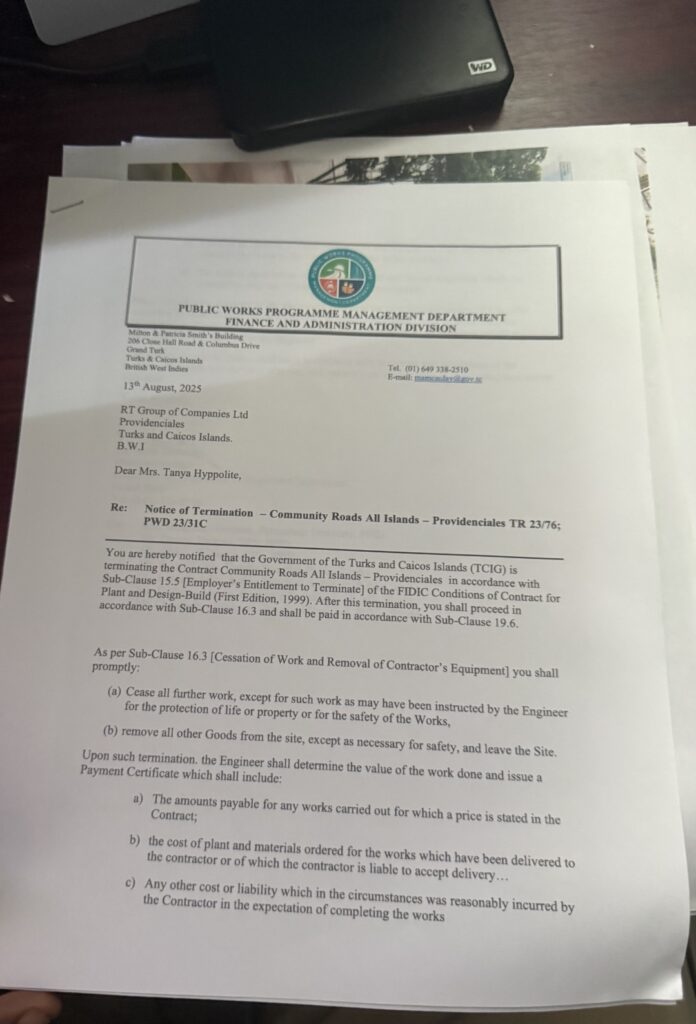

The controversy deepened when Government eventually issued a formal Notice of Termination.
Under the termination process, assessments were to be conducted regarding:
• Work completed;
• Materials delivered;
• Costs incurred;
• Equipment and plant associated with the project;
• Demobilization and removal expenses.
The outcome of those assessments could play a significant role in determining the final resolution of the dispute.
Public Deserves Full Explanation
The documents establish that a contract worth approximately $2 million was awarded, procurement activities were undertaken, a suspension notice was issued, legal correspondence followed, and the contract was eventually terminated.
What remains unclear is why a project that had advanced to the commencement stage ultimately failed to proceed.
As questions continue to circulate, many in the public will be looking for a comprehensive explanation regarding the decisions that led to the suspension and termination of the project and whether adequate oversight existed throughout the life of the contract.
Until those answers are provided, the circumstances surrounding the project are likely to remain a matter of significant public interest.
